How Long Does a Roof Replacement Take in N. Michigan?
Most homeowners are surprised by how fast a roof replacement actually goes. The decision to replace can take weeks of thinking. The replacement itself is usually done before the week is out.
For a typical home in the Traverse City area, a roof replacement takes one to three days of actual work. The timeline that matters to you, though, is the whole project: from the first call to the final cleanup, plan on two to four weeks. Most of that is scheduling and materials, not crew time on your roof.
Here’s a realistic breakdown of how long each part takes, what slows a job down, and the one variable that’s unique to Northern Michigan: the weather.
How Long Does the Actual Roofing Take?
The hands-on work is faster than people expect. For a standard asphalt shingle replacement on an average Traverse City home, here’s the typical crew time:
- Small or simple roof (under 20 squares, low pitch): 1 day
- Average home (20 to 30 squares): 1 to 2 days
- Large or complex roof (steep pitch, multiple valleys, dormers): 2 to 4 days
- Metal roof installation: 3 to 6 days
- Flat or low-slope (TPO/EPDM): 1 to 3 days depending on size
A “square” is 100 square feet of roof surface. Most homes here run 20 to 30 squares. A full crew can tear off, dry in, and reshingle an average roof in a day or two when the weather cooperates.
What Slows a Roof Replacement Down
A one-day roof becomes a three-day roof for predictable reasons. Knowing them ahead of time keeps the surprises down.
Roof pitch and complexity
A steep roof is slower and requires more safety setup. So does a roof with a lot of valleys, hips, dormers, skylights, and chimneys. Every penetration and every transition is hand-detailed flashing work that a wide-open ranch roof simply doesn’t have.
Rotten decking
Once the old roof comes off, we sometimes find sheathing that’s soft or rotted from old leaks. Replacing decking adds time and material. It’s also the most common reason a quote changes mid-job, which is why a good estimate notes it as a possibility up front. Our Traverse City roof cost guide breaks down how decking repair and other variables move the final price.

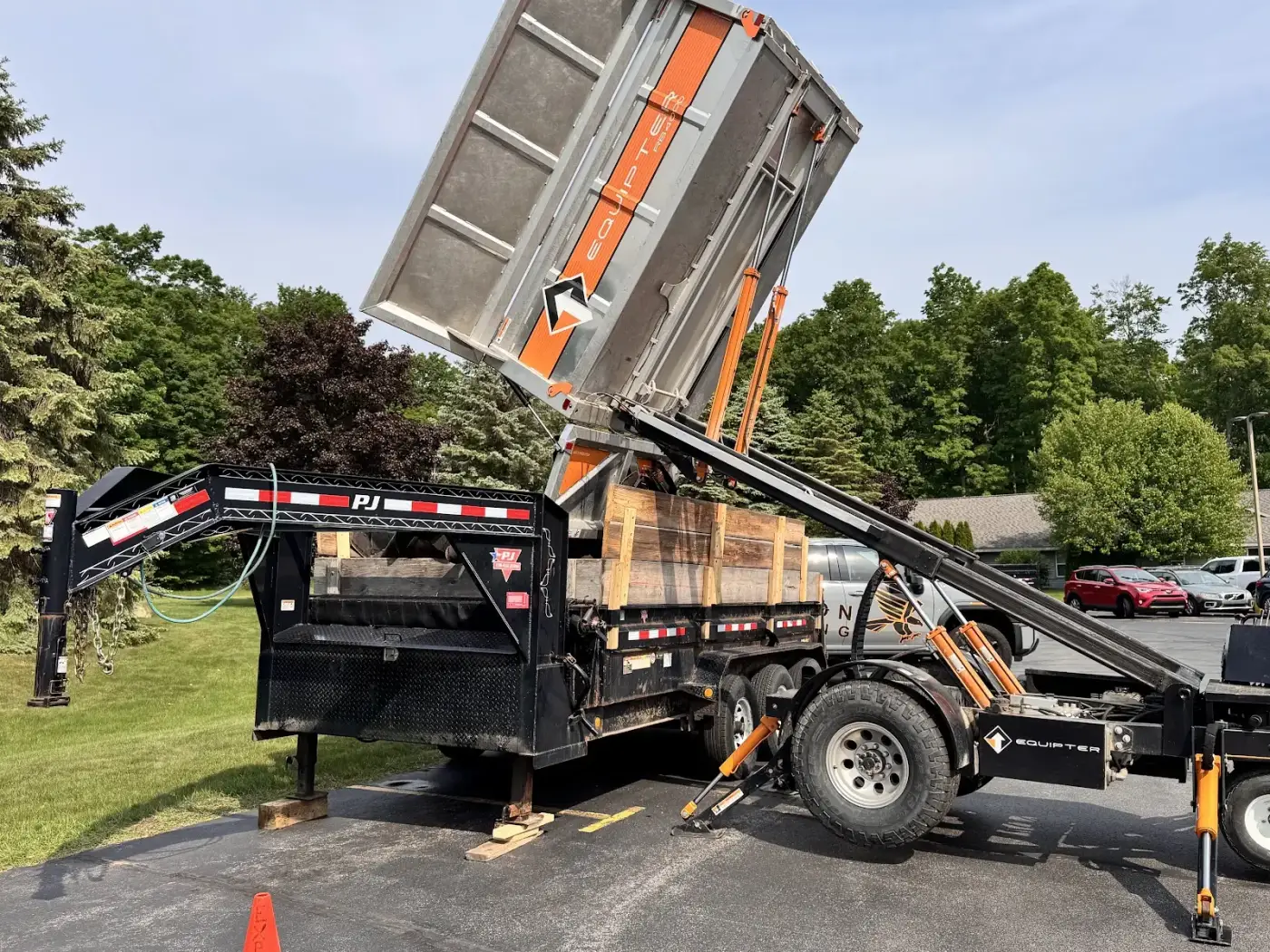

Tear-off layers
Stripping two layers of old shingles instead of one takes longer and fills the dumpster faster. Homes that already had an overlay take more tear-off time.
Weather
This is the big one in Northern Michigan, and it deserves its own section.
The Best Time of Year to Replace a Roof in Northern Michigan
If you have the choice, late spring through early fall is the sweet spot here. From about May through October, temperatures are reliable, days are long, and asphalt shingles seal the way they’re supposed to.
That timing matters because of how asphalt shingles work. Each shingle has a strip of sealant that bonds to the one below it when it warms up in the sun. That thermal seal is what locks the roof down against wind. In warm weather it happens within days. In cold weather it can be delayed for weeks or months until enough warm sun hits the roof, and until then the shingles are more vulnerable to wind.
The trade-off is that summer is also the busy season. The best crews book out, so if you want a summer install, get on the schedule early. Spring and fall often have more availability and perfectly good installing weather.
Can You Replace a Roof in Winter?
Yes, and up here we do it when we have to. A roof that’s actively leaking in January can’t wait until May. But winter roofing takes more care and a crew that knows the cold-weather rules.
Here’s what changes when we install in cold weather:
- Shingles get brittle. Cold asphalt cracks if it’s handled roughly, so the material gets kept warm and worked carefully.
- Sealant strips don’t bond right away. On winter installs we hand-seal shingles with roofing cement where the manufacturer calls for it, so the roof is locked down before spring.
- Snow and ice have to be cleared from the deck before anything goes on, which adds time.
- Days are short. Less daylight means fewer working hours, so a job that takes a day in July might take two in January.
What we don’t do is install over a frozen, snow-covered deck or rush a job in a storm. If it’s an emergency, we’ll tarp and dry-in the roof immediately to stop the leak, then complete the full replacement at the first safe window. If you’re dealing with a winter leak, our guide to emergency roof repair techniques covers what to do in the meantime.
The Full Project Timeline, Start to Finish
The crew is only on your roof for a few days, but the whole project runs longer. Here’s what to actually expect:
- Free inspection and estimate (day 1): We walk the roof, assess its condition, and give you a detailed quote, usually same day or next.
- Material selection and scheduling (a few days to two weeks): You pick the shingle and color. We order material and slot you into the schedule. Summer waits longer than spring or fall.
- Material delivery (1 to 2 days before install): Shingles and supplies arrive, often staged on the driveway or roof.
- Installation (1 to 4 days): Tear-off, deck inspection and repair, dry-in, and the new roof.
- Cleanup and final walkthrough (same day as finish): Full cleanup, magnetic nail sweep of the yard, and a walkthrough with you before we leave.
Realistically, most homeowners go from “yes, let’s do it” to a finished roof in two to four weeks, with weather and material availability being the main variables.
How to Keep Your Replacement on Schedule
A few things on your end keep the job moving:
- Book early for summer. The best windows fill up first.
- Clear the driveway and move vehicles so the dumpster and materials have a place to go and crews can work efficiently.
- Decide on color promptly. Material ordering can’t start until you do.
- Plan for the noise. Tear-off is loud. If you work from home or have pets, plan around the install days.
None of these are dealbreakers. They just shave days off the calendar.
Get a Straight Answer on Your Timeline
Every roof is a little different, and the only way to give you a real timeline is to look at yours. On a free inspection we can tell you the size, the pitch, the likely tear-off, and a realistic schedule for your home, plus whether it makes sense to do it now or wait for a better weather window.
Call us at 231-233-3530 or request a free estimate online. We serve Traverse City, Petoskey, Cadillac, and the surrounding Northern Michigan area. Not sure it’s time yet? Start with our guide to the signs you need a new roof.
